Week 11 of the city project

Week 11 of the City Project

We’re preparing for floor finishes which means a clean and tidy site! The carpet tiles have a unique pattern which will make the floor space pop once installed. We’re holding off installing the acoustic ceiling tiles due to risk of damage with significant cost to replace!

Week 10 of the city project

Week 10 of the City Project

Vinyl flooring well underway to the bathrooms and corridors. The abseilers have been on site this week fitting external air conditioning cowls to the outside of the building. There was significant Health & Safety preparation & co-ordination of fit out trades for this activity. The weather also didn’t play ball this week which is a factor you wouldn’t anticipate with a commercial office fit out.

Week 9 of the city project

Week 9 of the City Project

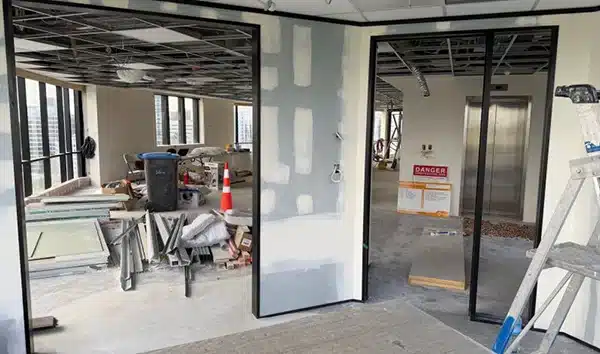

The pace of work on site is accelerating as we enter the final finishing phase. Vinyl layers & decorators have commenced work on site, doors are being hung, the carpentry to the spandrels is ongoing. As I look to the end of the project I’m micro planning activities day by day, week by week until handover.

Week 8 city project

Week 8 of the City Project

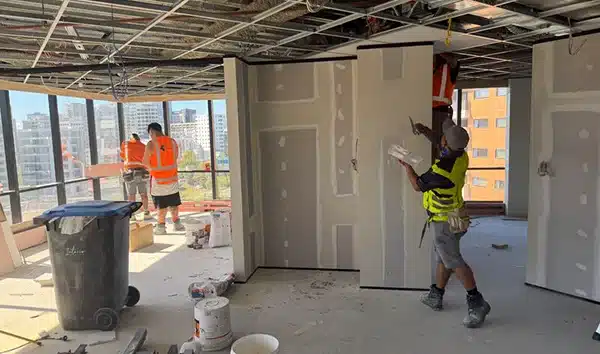

It’s very busy on site! 4 Weeks to go with the programme finely balanced. Stopping well underway, selected ceiling tiles going in. We’re undertaking progressive floor levelling as we have floor mounted roller doors. Note to self for future projects – expect buildings built in the 80’s to have high points around the perimeter columns.

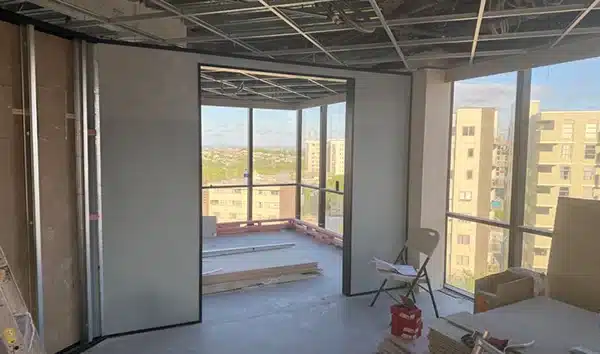

Week 7 city project

Week 7 of the City Project

Office partitions are flying up, stopping has commenced & fire rated spandrel panel installation is well underway. The time to make changes to layout has passed. My key focus is co-ordinating the team & sequencing work to avoid undue delay. I’m planning ahead but reacting to the inevitable daily challenges. Its a fine balance as every decision has a knock on effect. It’s intense but at the same time rewarding.

Week 6 city project

Week 6 of the City Project

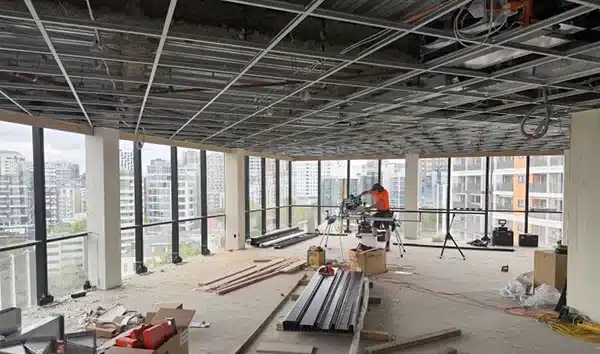

The suspended ceiling grid is in, work has commenced on the internal partitions. We’re working closely with the Architect to fine tune the original set out dimensions. When you’re working with an existing structure there is always minor adjustments to the layout.

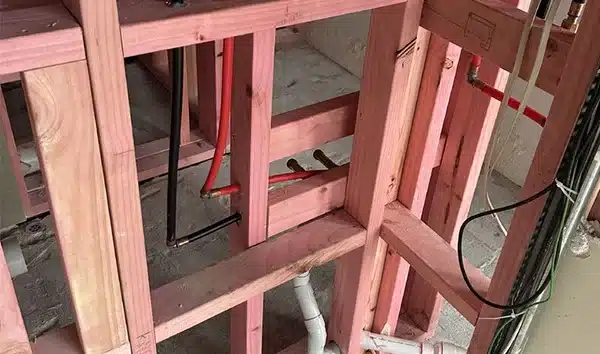

Week 5 city project plumber is undertaking first fix pipework

Week 5 of the City Project

1st Fix services to the ceilings is largely complete. The plumber is undertaking first fix pipework to the bathrooms with the electrician to follow shortly after. The suspended ceiling contractor has commenced installing ceiling grid. Overall, it’s a critical time on site – we’re almost 50% through and notably tracking to the original programme. We have great collaboration with the sub contract teams and positive feedback from the Body Corporate.

Week 4 of the city project

Week 4 on the City Project

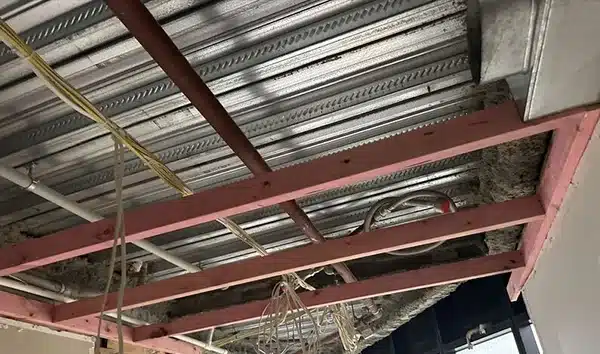

We’re framing out the bathrooms and continuing 1st Fix Services & passive fire treatment to the curtain walls. The ceiling void is approximately 400mm & down to 100mm in places where there are down stand beams. We have co-ordinated the services carefully in the ceiling void, working as a team to mitigate clashes in pipework etc

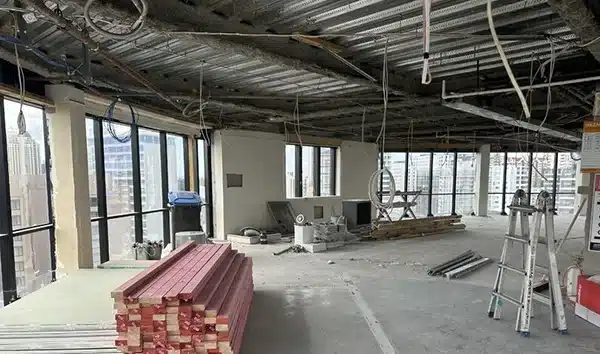

Week 3 of the city project

Week 3 of the City Project

Demolition is complete, 1st Fix services underway. The external perimeter slab to curtain wall connections need specialist passive fire treatment to floor and ceiling. Build materials need to be either cut down to fit in the lift or walked up the fire stairs.

Week 2 of the city project

Week 2 of the City Project

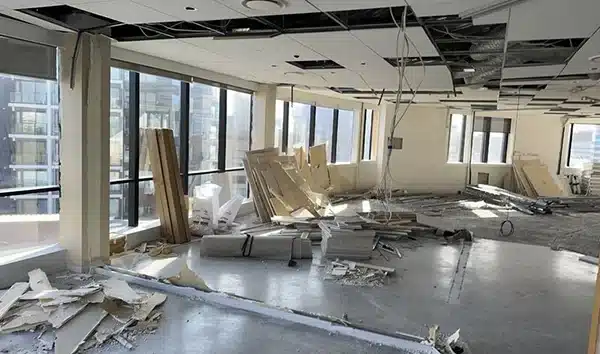

Demolition is well underway. The demolition sub contractor is sorting materials and recycling where they can. We have residents above and below the fit out floor with restricted working hours for noisy work. Loading out is also restricted. IDB is working closely with the Body Corporate for noise compliance.

Idb is pre-start at the double floor fit out in the city-img

IDB is Pre-Start at The Double Floor Fit out in the City

Considerable time is taken upfront to programme the work carefully. We liaise with the Body Corporate for site access & operational compliance. The sub contractors understand its a collaborative team effort. Communication is key.

Design & build partnership with moller architects

Design & Build Partnership with Moller Architects

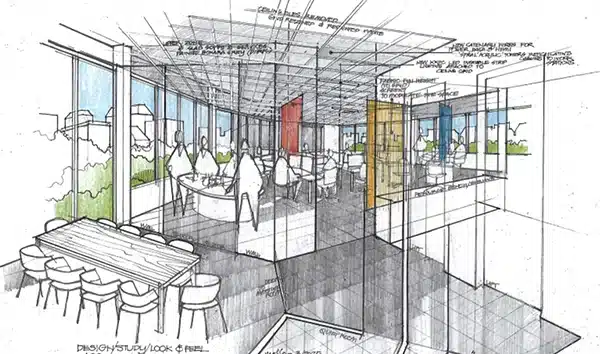

IDB is pleased to announce a design & build partnership with Moller Architects for a double floor fit out in Auckland CBD. IDB will be documenting the fit out process over the next 3 Months. In a world of CAD Drawings it great to see old school renders as part of the initial concept.
